Nostag 10 cable-lay vessel on the Singapore – Malaysia Interconnector
Cable Lay · Power Interconnect · Project Recovery

Singapore – Malaysia Interconnector

Woodlands · 230 kV Power + Auxiliary · Nostag 10

Region Singapore — Malaysia (Straits of Johor) Programme 3-Month Mid-Project Takeover

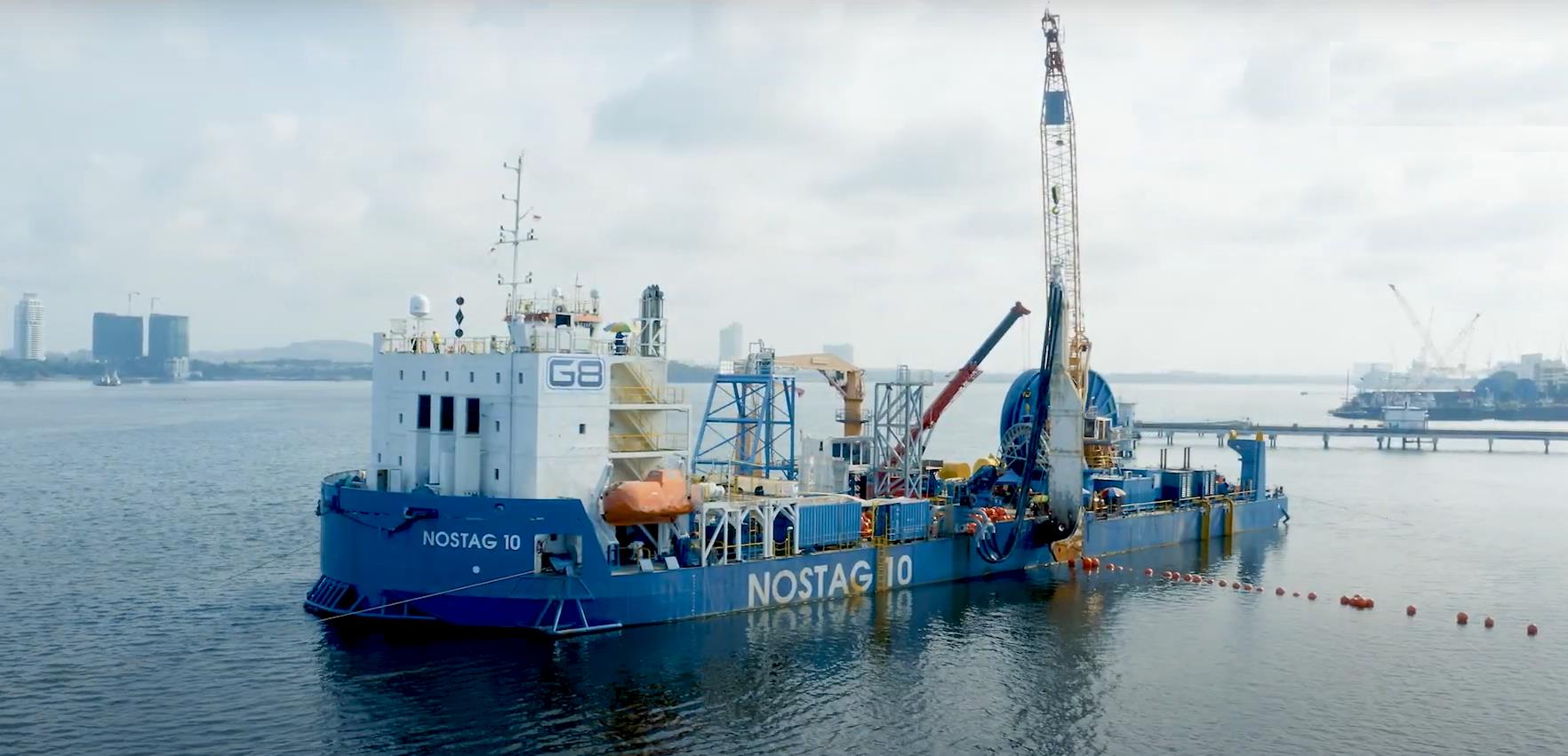

Took over the project mid-stream for SP Group and LS Cable & System after the previous contractor walked off halfway. Dimension completely remobilised the vessel — reel-drive and full cable-lay system — drove the MWS approval cycle, rebuilt the project procedures and mobilised & operated the Vertical Injector in 3 months, on the Singapore – Malaysia 230 kV Woodlands interconnector.

3months
Mid-Project Recovery
230kV
Power Cable Voltage
8 + 6
Power + Auxiliary Cables
Nostag 10
Cable Lay Vessel
The Challenge

Picked Up Halfway. Back Offshore in 3 Months.

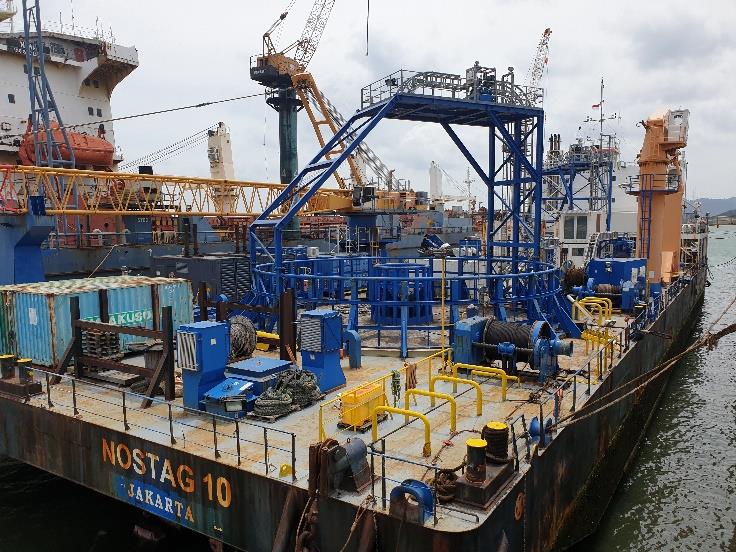

The previous contractor walked off the Singapore – Malaysia Woodlands interconnector with the project halfway through. Dimension was brought in by SP Group and LS Cable & System to take over and rescue the programme — completely remobilising the vessel with reel-drive and a full cable-lay system, driving the MWS approval chain, rebuilding the project procedures from scratch, and mobilising and operating the Vertical Injector for cable burial. Three months from takeover to back offshore.

  • 01Mid-Project TakeoverInherited a stalled programme after the prior contractor demobilised — clients still on the hook for delivery.

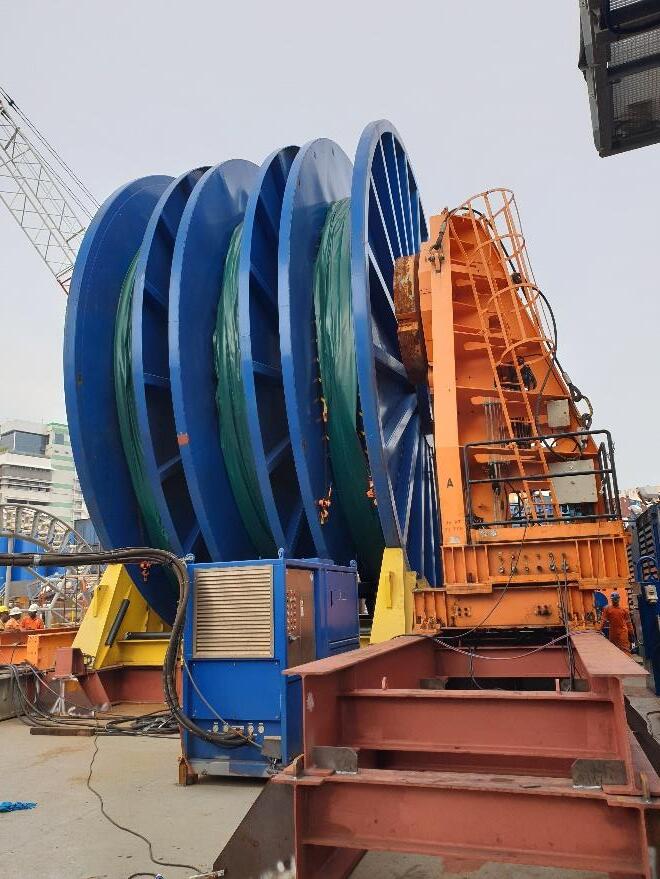

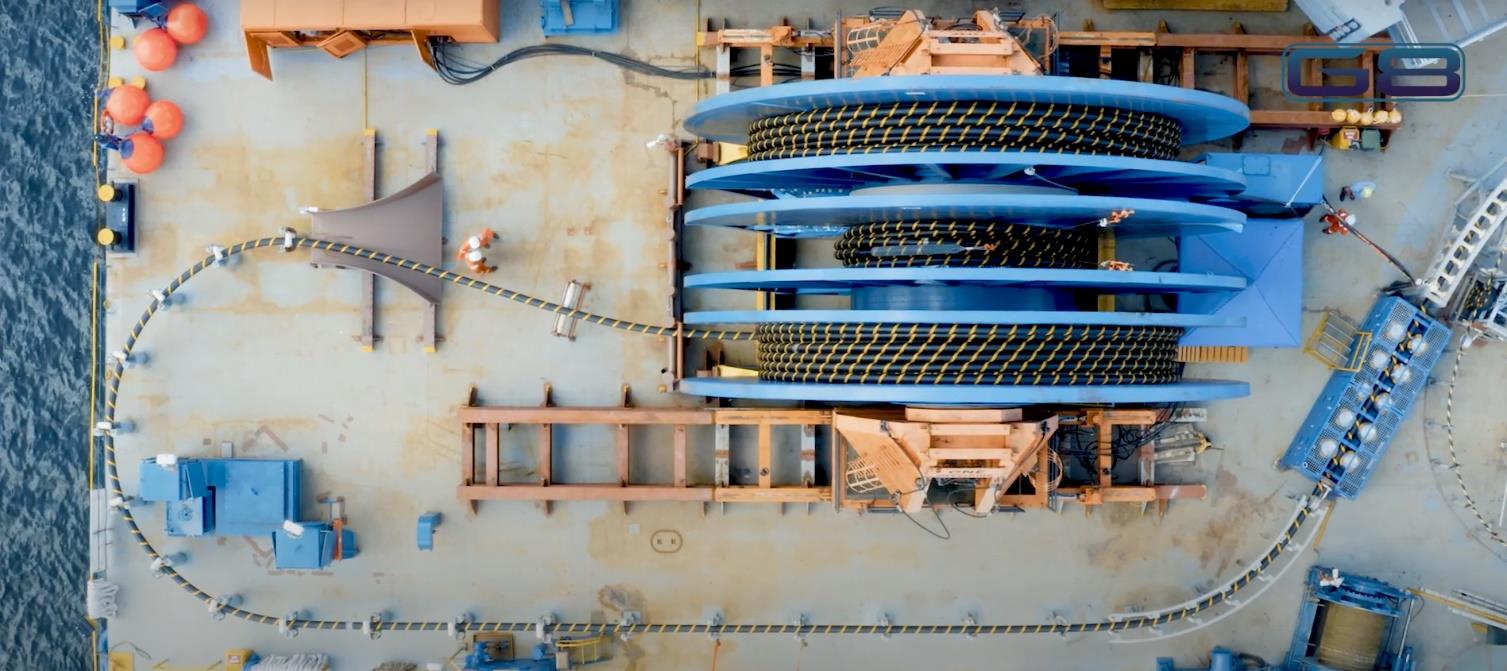

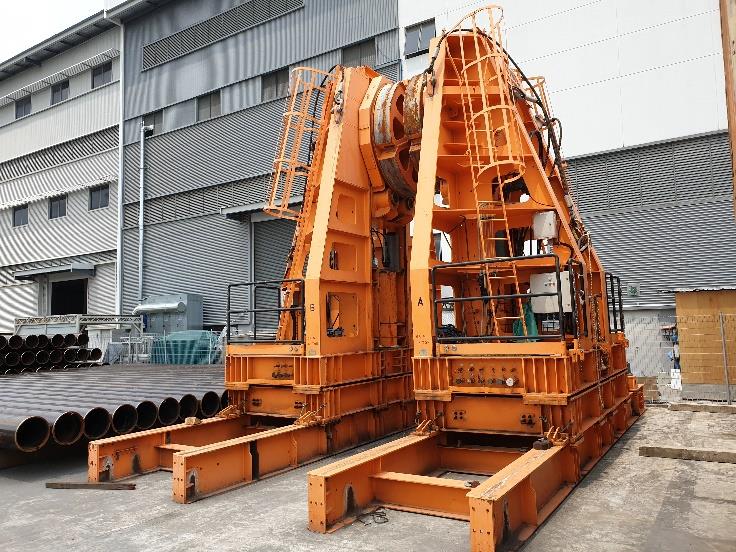

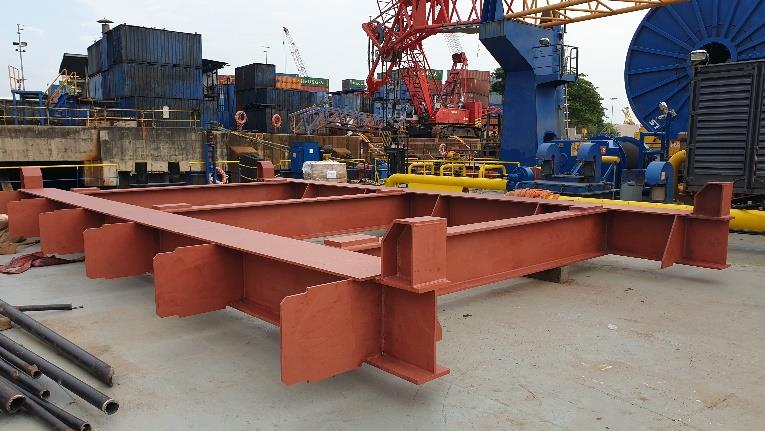

  • 02Full Vessel RemobReel-drive, tensioner and full cable-lay system re-engineered, re-installed and re-commissioned on Nostag 10.

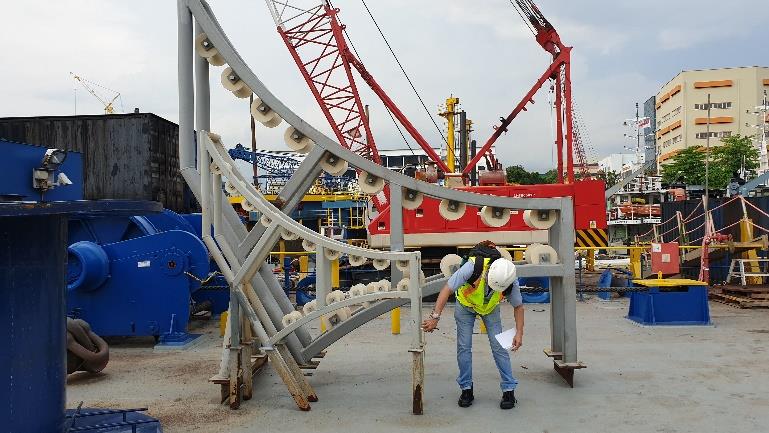

  • 03MWS & ProceduresWhole MWS approval cycle and the project procedures rebuilt from scratch under Dimension's name.

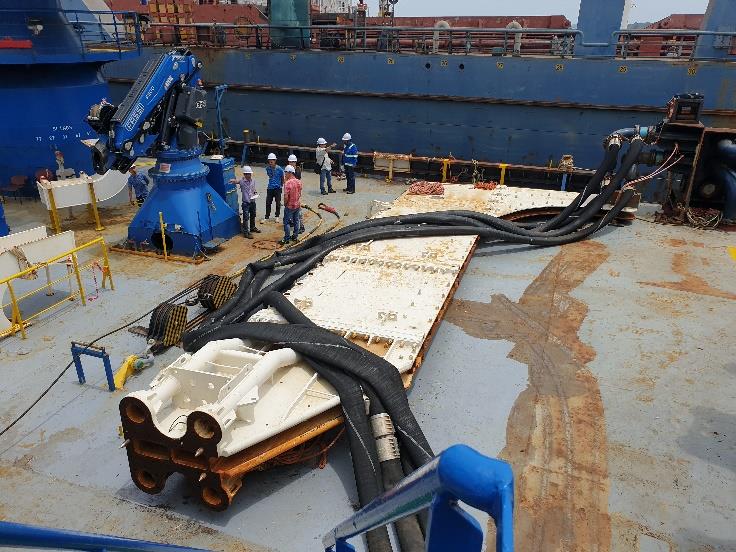

  • 04VI Mob & OpsVertical Injector mobilised onto the spread and operated for the cable burial phase — inside the same 3-month window.
Project Information
Main ClientTenaga Nasional Berhad (Malaysia) & SP Group (Singapore)
Main ContractorLS Cable & System
Sub-ContractorG8 Subsea Pte. Ltd.
Cable-Lay VesselNostag 10

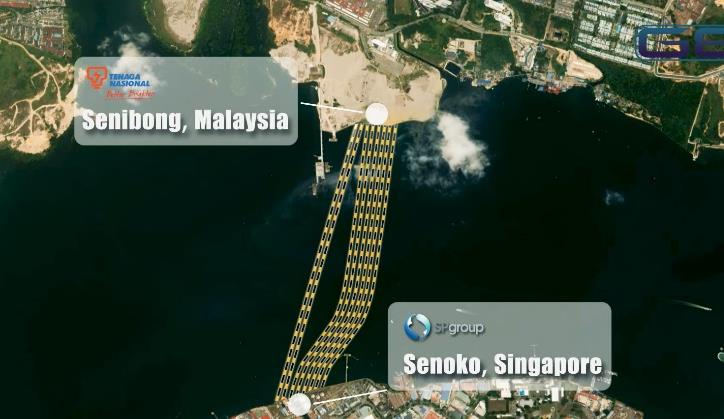

Project LocationSenoko, Singapore — Senibong, Malaysia
Cable Set8 × Power Cable + 6 × Auxiliary Cable
Overview

Singapore – Malaysia Interconnector

SP PowerAssets (SP Group) and Tenaga Nasional Berhad (TNB) commissioned two new 230 kV cable circuits — land and submarine — to strengthen the interconnection between the Singapore and Malaysian power networks. LS Cable & System was the main contractor for supply and installation of the two circuits and auxiliary cables across the Straits of Johor, from Woodlands, Singapore to Johor Bahru, Malaysia.

Mid-programme, the original installation contractor demobilised. Dimension was brought in by SP Group and LS Cable & System to take over and rescue the project — completely remobilising the Nostag 10 with the reel-drive and cable-lay spread, driving the MWS approval cycle, rebuilding the project procedures and mobilising and operating the Vertical Injector for cable burial. The recovered programme was returned to offshore operations in 3 months.

Technical Details

Technical Data

ParameterValue
Power Cable TypeLS-230 kV 1C 2500 SQ
Power Cable Outer Dia.179 mm
Power Cable Dry Weight81 kg/m
Aux Cable 1 TypeOptical, 20-pair telephone & 10-core LV
Aux Cable 1 Outer Dia.44.9 mm · 78.1 mm · 63.4 mm
Aux Cable 1 Dry Weight4.2 kg/m · 12 kg/m · 8.1 kg/m
Highlights

What Made It Notable

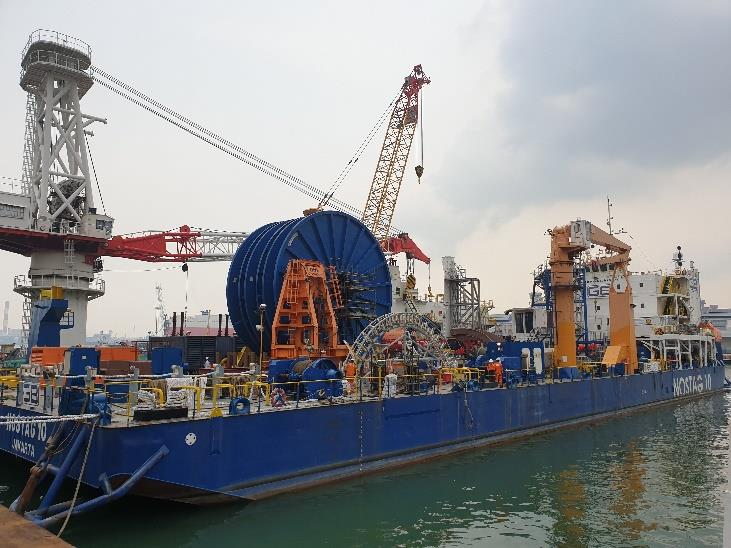

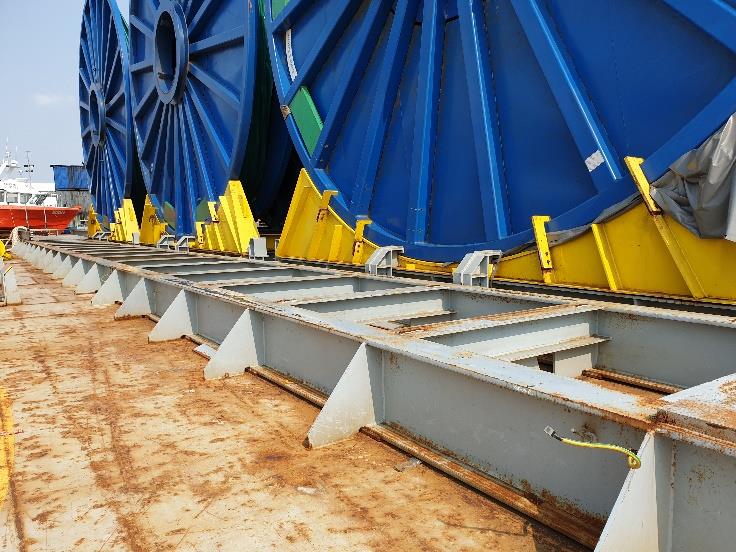

Route & Deck Context

Cable Laying Area

Project Gallery

From the Field

Related Studies

More Deliveries

Engage Dimension

Got a project like this?

Talk to our engineering team about feasibility, FEED, equipment supply or offshore execution support.
