TPC II Shore Pull-In
Shore Pull · Landfall · TPC II

TPC II Shore Pull-In

Changhua Phase 2 — 300 MW Offshore Wind Farm Export Cable Landfall

Year 2025 Region Taiwan Programme 3-Month TJB Pull-In

Bathymetry data shifted late in the cycle. Dimension redesigned the shore-pull strategy with a new HDD elevation and redeployment, and managed the TJB pull-in for three 161 kV export cables in 3 months in the challenging Taiwan landfall environment.

3months
TJB Pull-In Cycle
3
Export Cables
850m
Cable Float-out
700m
HDD Pull-in
The Challenge

Bathymetry Shift. 3-Month Pull-In Window.

Updated bathymetry data arrived late in the programme with a substantial change to the seabed profile, breaking the original landfall plan. Dimension redesigned the entire shore-pull strategy, including a new HDD elevation and a redeployment of the float-out and barge configuration, then ran the TJB pull-in for three export cables in three months through the challenging Taiwan landfall environment — currents, monsoon weather windows and a tight intertidal zone.

  • 01Bathymetry RedesignSubstantial seabed-profile change forced a from-scratch redesign of the shore-pull and HDD strategy late in the cycle.
  • 02New HDD ElevationRe-elevated HDD path engineered, validated and re-deployed without losing the landfall window.
  • 033-Month TJB Pull-InFull TJB pull-in for three 161 kV export cables completed in a 3-month execution window.
  • 04Taiwan EnvironmentCurrents, monsoon weather windows and an active intertidal zone managed through method statements and live-ops adaptation.
Project Information
Main ClientTaiwan Power Company (TPC)
Main ContractorShinfox Energy
CountryTaiwan
Year2025
ProgrammeChanghua Phase 2 — 300 MW Offshore Wind Farm
Key AssetsCLV Ndurance · HY02 Barge
Overview

TPC II Shore Pull-In

As part of the wider TPC II contract, Dimension successfully completed the shore pull-in operation of three 161 kV export cables for the Changhua Phase 2 — 300 MW offshore wind farm. The scope for each export cable covered 850 m of cable float-out, an intermediate barge for HDD and cable handling, 700 m of pull-in through HDD, and the final pull-in inside the Transition Joint Bay (TJB) up to the land-cable termination.

Technical Details

Technical Data

ParameterValue
Export Cable Voltage161 kV
Export Cable Diameter280 mm
Export Cable Length22 km per cable
Number of Lines3
Total Cable Weight≈ 8,700 tonnes
Highlights

What Made It Notable

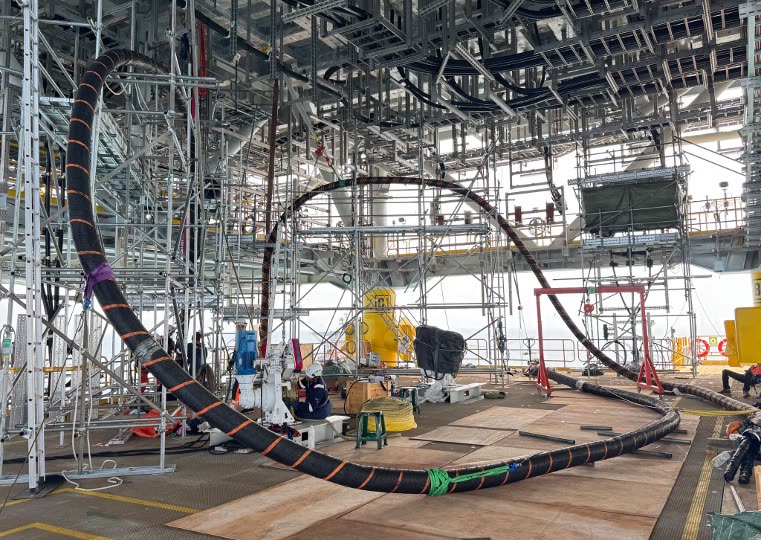

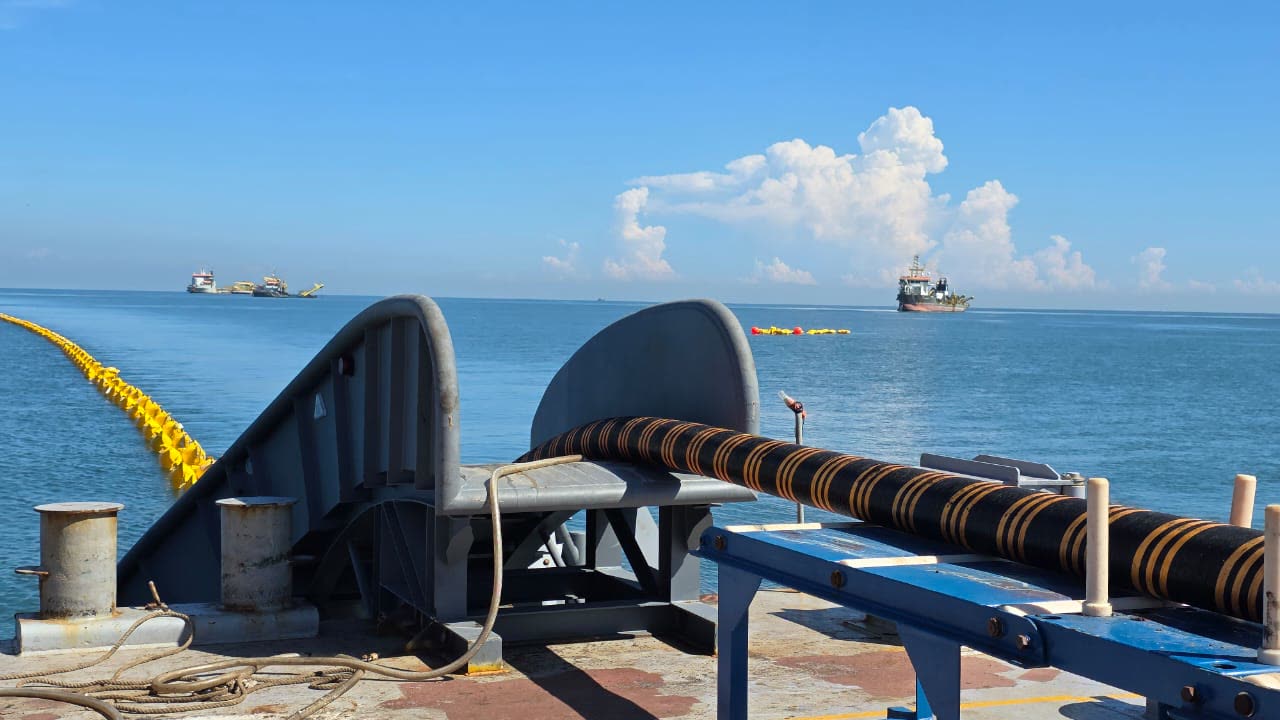

Project Gallery
